Council has several conflicts of interest. Consent Authority, co-proponent, and environmental regulator !!!
Afternoon storm on 25 December 2025: Storm 5
Directing muddy stormwater releases from site to the creek fails to prevent road flooding!
Key takeaways:
fifth time construction site stormwater pollutants and debris flowed into creek and partly blocked roads in 53 days.
Site monitoring during storms? Council were informed when a neighbour rang council's after hours hotline.
clean up occurred with an early start on Boxing Day.

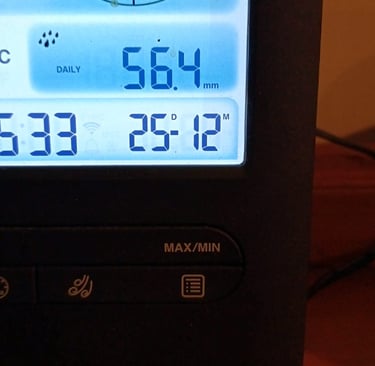

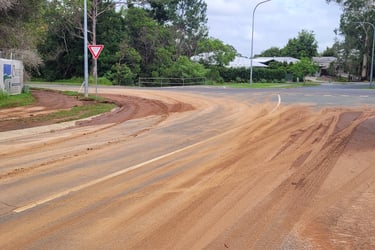

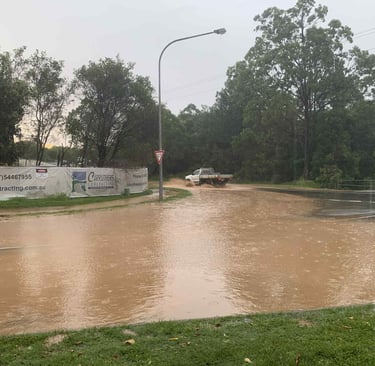

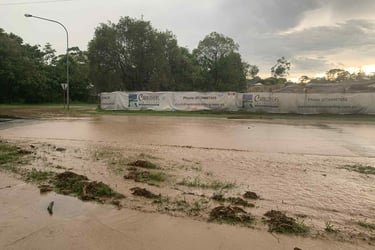

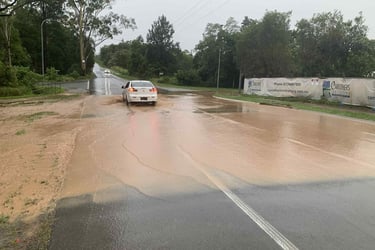

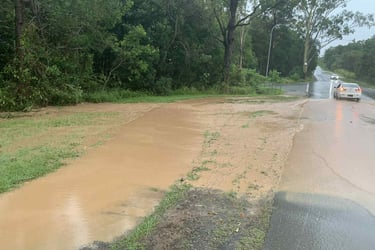

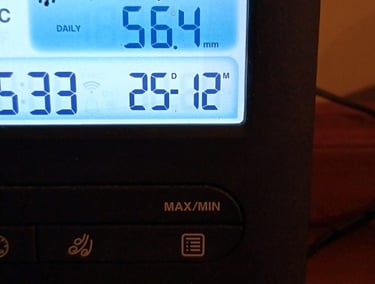

The first photo on the right (below on mobile) shows rainfall of 56mm in under an hour. Other photos and linked videos show the aftermath of the storm which was a polluted creek and more filth on the road as usual.

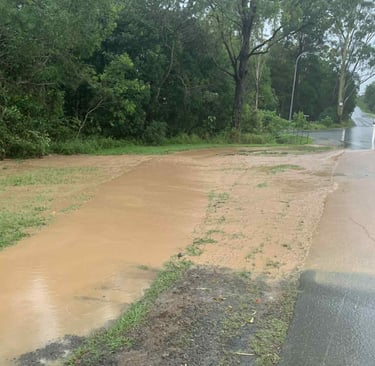

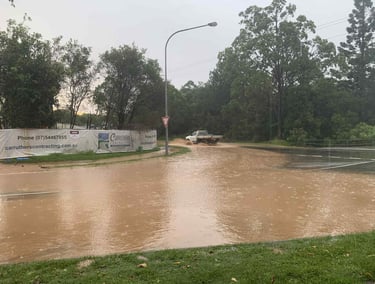

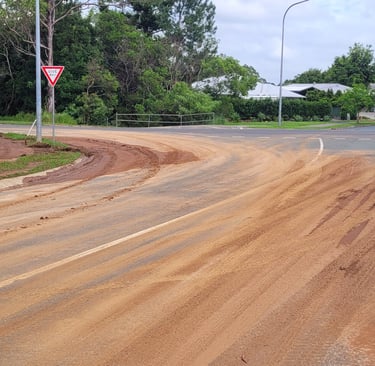

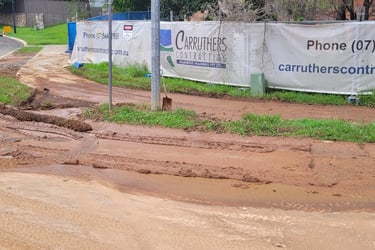

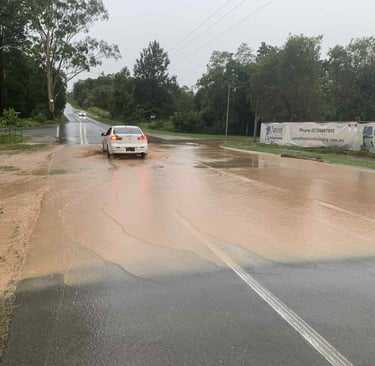

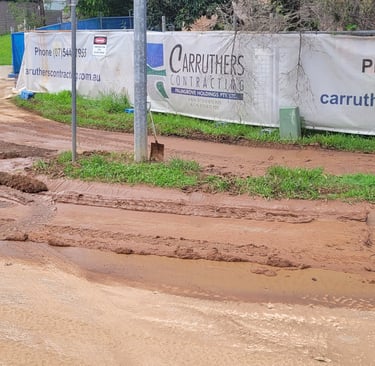

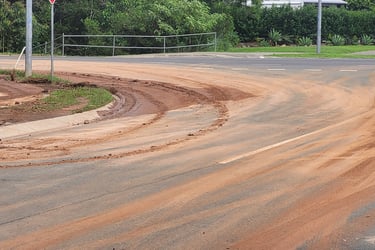

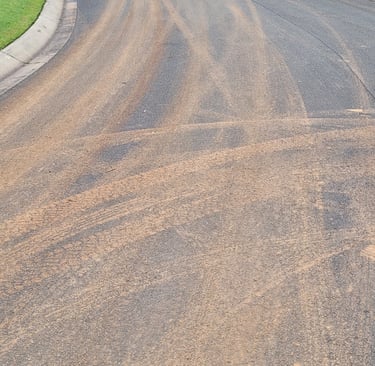

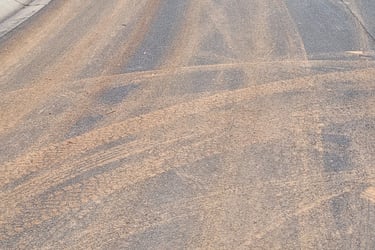

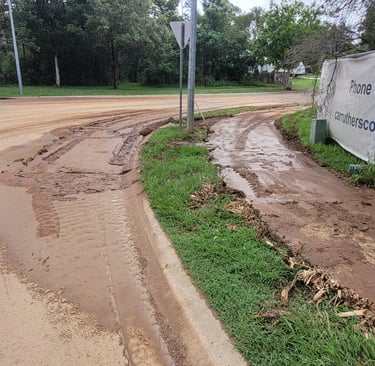

Photos show the Dianella Court and Wilgee Court area after approx 56 mm of rain in under an hour. Not an unusual event - the fifth in 53 days.

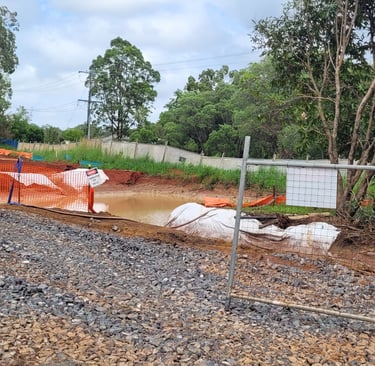

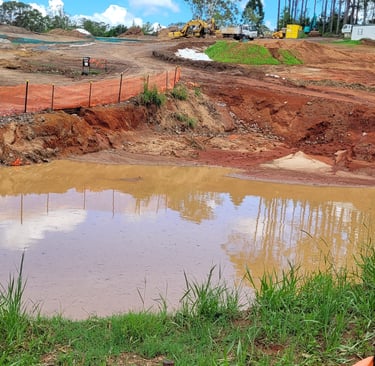

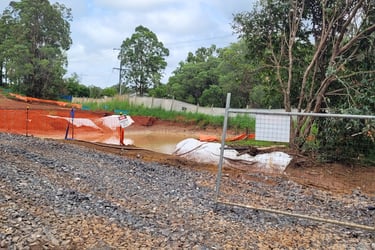

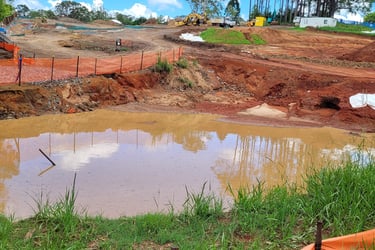

Labelled photos above and below show the stormwater diversion agreed by council (sediment basin overflowing direct to creek to protect intersection).
